The Cost of Disconnection: Hatirjheel Ecological Study
FURP-D-25-00085 Research Summary

The Cost of Disconnection

Quantifying the urban ecological resistance between the Hatirjheel Special Area and Dhaka's regional water network.

Urban Fragmentation in Dhaka

Rapid and dense urban growth in the Dhaka Metropolitan Region (DMR) has fractured vital green and blue spaces. The Hatirjheel Special Area (HSA), a critical water retention and recreational zone, is becoming ecologically isolated.

The Core Issue: Traditional planning often ignores functional connectivity. Without connection to regional rivers, Hatirjheel risks losing its ecological integrity.

Context: Hatirjheel Area

Methodology: Calculating Resistance

Using GIS Least-Cost Path (LCP) modeling, we assigned "Friction Costs" to different land uses based on the RAJUK DAP 2022-2035.

Table 2: Ecological Resistance Matrix

Transport / Communication 150 Units

Absolute linear obstacle. Highly impervious.

Commercial / Industrial 75 Units

High density & human activity. Area-wide barrier.

Residential / Institutional 35 Units

Moderate density. Significant landscape cost.

Water / Open Space 1-10 Units

Optimal habitat. Lowest resistance.

Spatial Analysis Results

Total Accumulated Cost (TAC): 776,104 Units

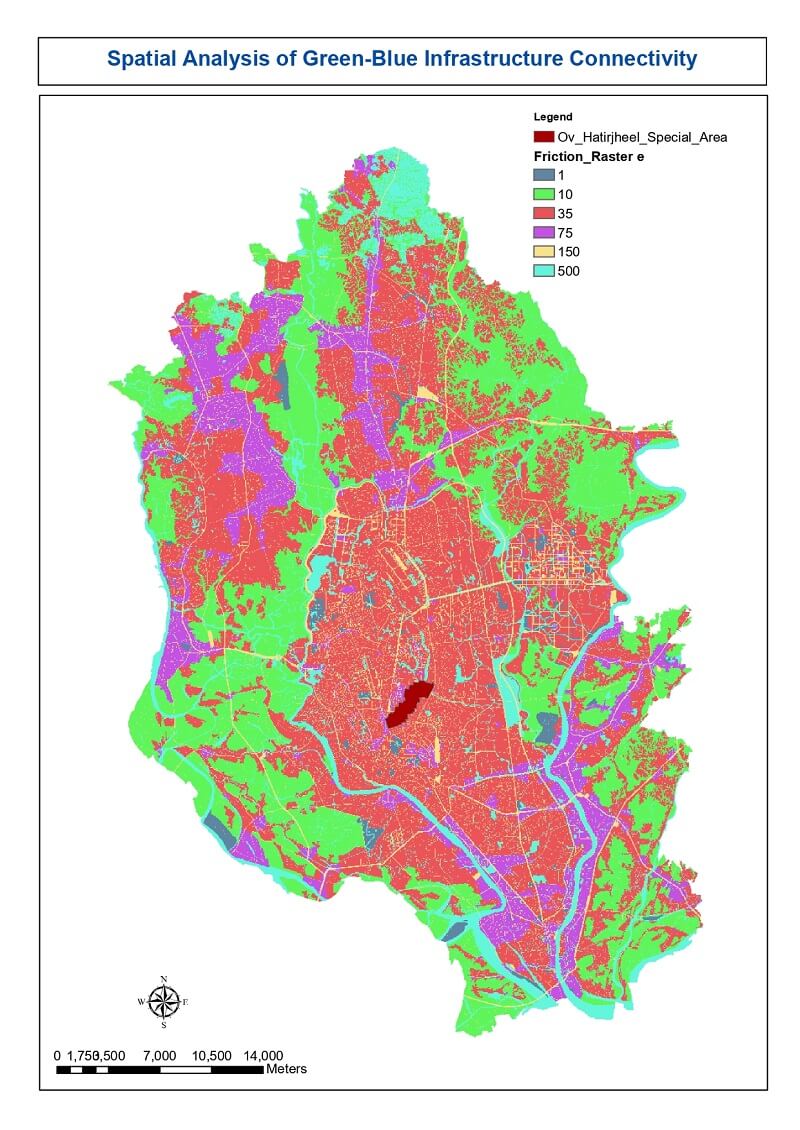

Resistance Surface

Visualizes the cost of movement. Red areas (Transport) act as absolute barriers to ecological flow.

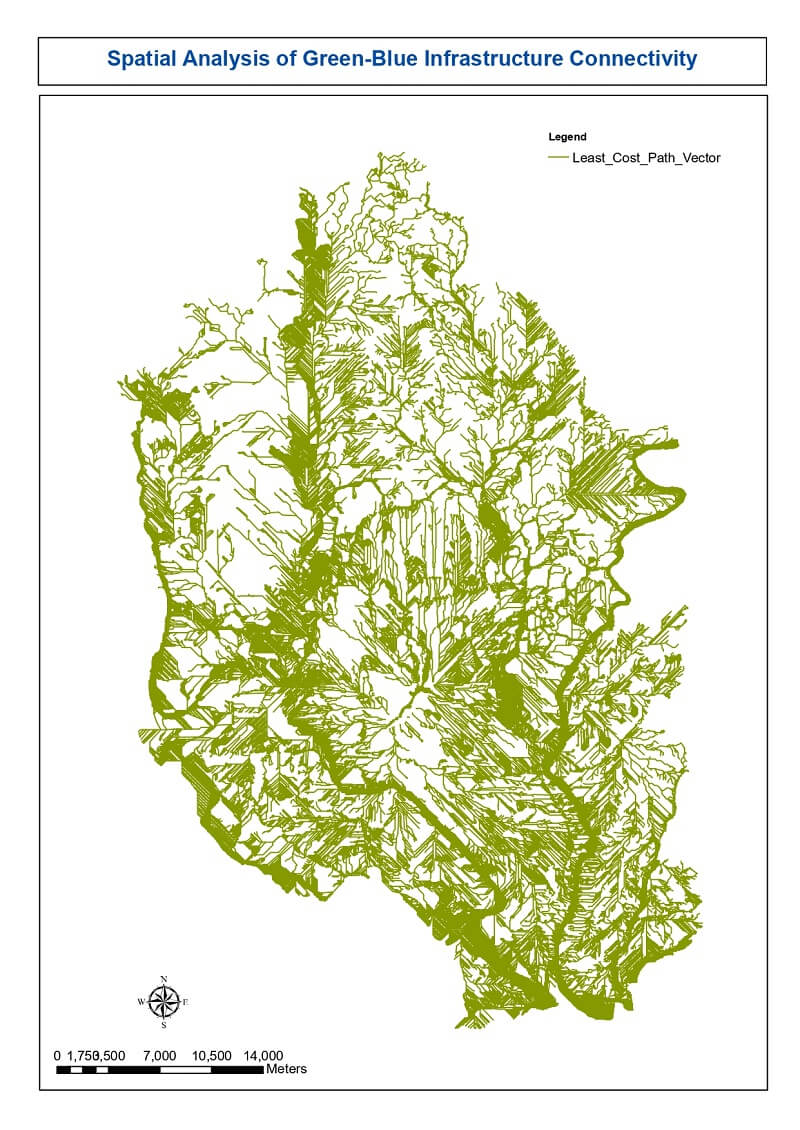

The Optimal Path

The Least-Cost Path (LCP) winds through the city, finding the path of least resistance.

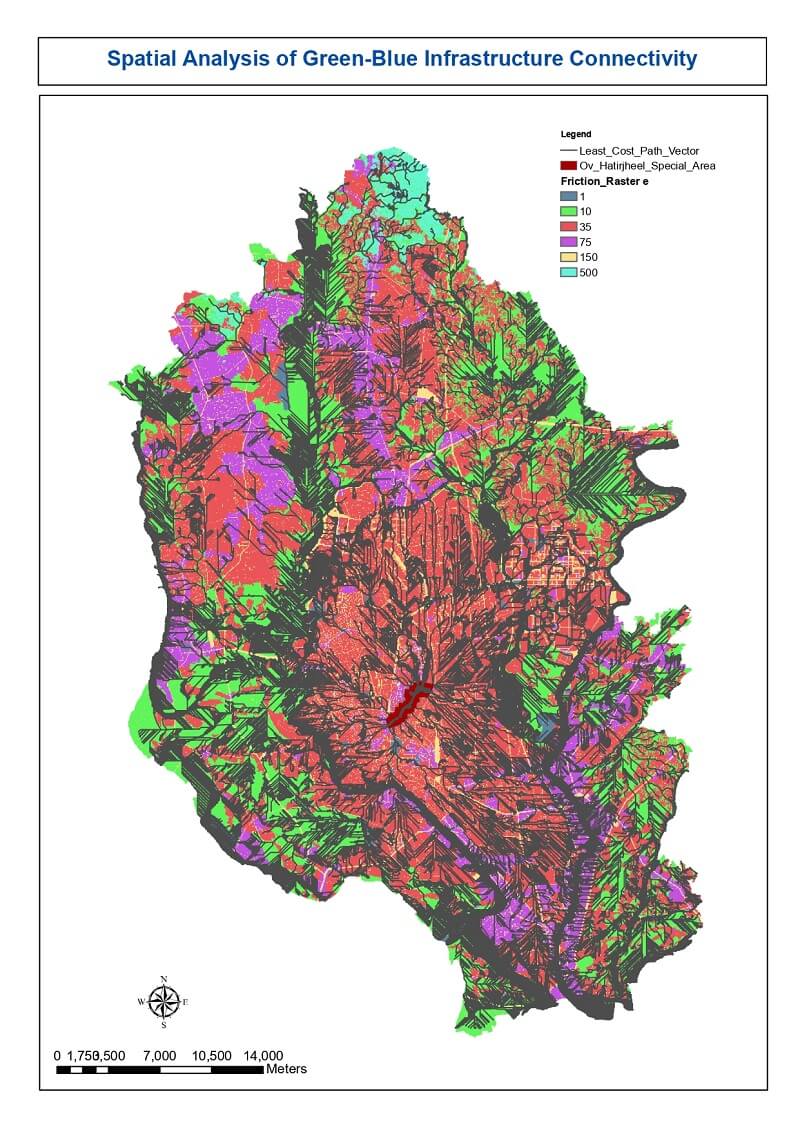

Regional Linkage

Shows how the corridor connects Hatirjheel to the broader river network, highlighting intervention points.

Policy Recommendations

1

Prioritize Land Use Intervention

Resources must focus on securing and restoring specific land parcels intersected by the Optimal Ecological Corridor found in Figure 2.

2

Infrastructure Retrofitting

Implement vegetated wildlife underpasses or eco-ducts to reduce the resistance cost of transport infrastructure (currently 150 units).

3

Mandatory LCP Assessment

Future large-scale projects should be mandated to conduct a Least-Cost Path assessment to ensure they do not increase the Total Accumulated Cost above the baseline.

© 2025 Research Summary. Based on the paper "The Cost of Disconnection".

Author: Joy Biswas | Data Source: RAJUK DAP 2022-2035
